Stucco Facade Details and Assemblies

Introduction

A stucco façade is never just the finish coat you see from the sidewalk. It's a coordinated wall assembly that manages water, air, heat, structural movement, and impact, all while delivering the look the design team intended.

Many project teams treat stucco as a surface-level decision, then struggle later with cracking, staining, or leaks traced back to a missed detail at a window head or control joint.

Water intrusion remains one of the most common reasons commercial façades fail prematurely. Most of those failures trace back to transitions, not the field of stucco itself.

This article is written for architects, commercial general contractors, developers, and property managers who need a practical understanding of how stucco and EIFS assemblies go together. We'll cover assembly layers, critical junction details, finish selection, and maintenance.

One caveat throughout: final details must always follow your project's drawings, applicable codes, the tested system requirements, and the manufacturer's published instructions. This article provides a framework, not a substitute for those documents.

Key Takeaways

  • A durable stucco facade depends on the full wall assembly, not the finish coat alone
  • Long-term performance hinges on substrate compatibility, drainage, reinforcement, flashings, and movement joints
  • Traditional stucco and EIFS differ in substrates, layering, and moisture-management strategy
  • Most facade failures happen at transitions and penetrations, not uninterrupted field areas
  • Bring in an experienced exterior wall contractor early to review sequencing and constructability

The Anatomy of a Stucco Façade Assembly

Before any texture goes on the wall, several layers have to work together: the substrate, a water-resistive barrier, reinforcement or lath, drainage provisions where required, and the plaster or EIFS coats themselves. Skip or mismatch one layer, and the whole system is compromised.

Traditional Three-Coat Stucco

Traditional stucco relies on metal lath over sheathing and an air/water barrier, with Portland cement plaster applied in three distinct coats. According to AWCI's technical resource on exterior finishing, a typical assembly reaches a nominal overall plaster thickness of about 7/8 inch.

Each coat has a job:

  • Scratch coat – applied over lath and scored to create a mechanical key for the next layer
  • Brown coat – builds thickness and levels the surface
  • Finish coat – provides the final texture, color, and weather exposure

Layer thicknesses, cure times, and reinforcement requirements vary by project. Always verify these against the specification and current ASTM standards, including ASTM C926 for plaster application and ASTM C1063 for lathing and furring.

Direct-Applied Stucco Over Masonry

On concrete or suitable masonry substrates, stucco is sometimes applied directly without a lath-based drainage cavity. This approach depends heavily on bond quality, surface preparation, and moisture management, since there's little or no drainage plane to rely on if water gets behind the finish.

Direct application is not interchangeable with a lath-based or framed-wall assembly. Substituting one for the other without re-engineering the detailing invites trouble.

EIFS: A Different Kind of Assembly

EIFS, or synthetic stucco, is a layered system. Per the EIFS Industry Members Association, it's a non-load-bearing cladding built from attached insulation board, a glass-fiber-mesh-reinforced base coat, and a textured finish. EIFS with drainage adds an air/water-resistive barrier and a dedicated drainage path for incidental moisture.

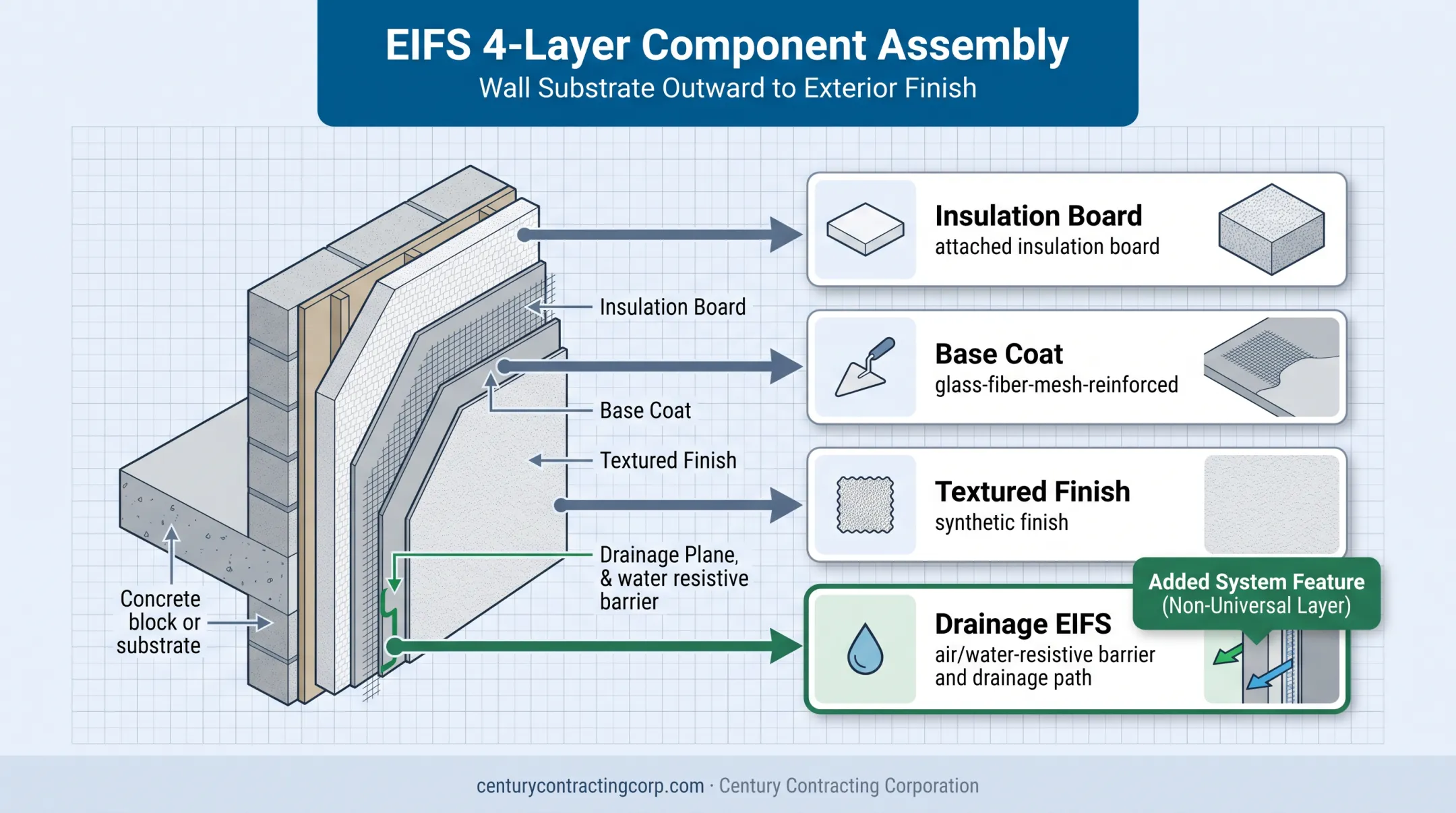

EIFS wall assembly layers and drainage components diagram

Metal lath isn't a standard EIFS component, which is a key reason the two systems shouldn't be detailed as if they were variations of the same thing.

Traditional Stucco vs. EIFS at a Glance

Factor Traditional Stucco EIFS
Substrate Lath over sheathing, or direct to masonry Sheathing with mechanically attached insulation
Weight Heavier, cementitious Lightweight, foam-based
Insulation Added separately in the wall cavity Built into the system
Drainage Depends on configuration Drainage planes common in EIFS with drainage
Crack resistance Prone to shrinkage cracking Flexible base coat resists hairline cracking

Avoid treating either system as universally superior. Performance depends on correct detailing, not the material alone.

Staying Within the Tested System

The 2024 IBC requires EIFS with drainage in framed Type V walls for Groups R-1 through R-4, with an average minimum 90% drainage efficiency tested under ASTM E2273, per IBC Section 1407.4.1. Assemblies incorporating foam plastic insulation also need to comply with NFPA 285 fire-propagation testing under IBC Section 2603.5.5, subject to stated exceptions.

Every component (primer, base coat, mesh, sealant, flashing, finish) needs to come from the approved, tested system. Swapping in a compatible-looking product from a different manufacturer can void the system's fire and water-resistance testing.

Century Contracting Corporation works with architects and GCs as a commercial subcontractor certified by Dryvit, STO, Senergy, Parex, and Finestone. The company self-performs specified stucco, EIFS, and air/weather barrier scopes so the installed assembly matches what was tested and approved.

Critical Stucco Façade Details

Stucco fields rarely fail on their own. Problems concentrate at transitions, penetrations, terminations, and changes in plane: exactly where water, movement, and material differences converge.

Base-of-Wall and Grade Transitions

The base of a stucco wall needs clearance from paving and soil, along with drainage or weep provisions so trapped water can escape. Per JLC's stucco field guide, the weep screed at this location does double duty: it sets plaster thickness and provides an exit path for moisture behind the cladding.

Also coordinate:

  • Protection from splashback and impact near grade
  • Clean termination of reinforcement
  • Tie-in with foundation waterproofing or below-grade systems

Verify exact clearances against project documents and the system manufacturer's details. These aren't one-size-fits-all numbers.

Windows, Doors, and Openings

Openings need properly integrated sill, jamb, and head flashings, with back dams or equivalent water-control measures where specified. AWCI's illustrated stucco and EIFS details both show flexible flashing at rough openings and sill pans that drain positively outward.

Rough-opening tolerances, casing beads, and trim sequencing all affect the finished reveal and whether water actually sheds away from the opening rather than pooling at the sill.

Roof-to-Wall, Parapets, and Horizontal Surfaces

Parapets, copings, and balconies concentrate runoff, which makes positive drainage and counterflashing non-negotiable. AWCI's published details specify coping faces extending at least 2½ inches below the upper edge of EIFS or over the stucco finish. Confirm that dimension against your specific system's documentation rather than assuming it applies universally.

Horizontal ledges and projections need slopes and drips built in. Without them, water runs back toward the wall instead of away from it.

Control Joints and Movement

Joint placement should respond to real building movement, not just aesthetics. Factor in:

  • Structural breaks and panel dimensions
  • Changes in substrate or thickness
  • Expected thermal and seismic stress

Execution details matter as much as placement:

  • Run joint accessories continuously through the assembly
  • Use sealants compatible with adjacent materials
  • Maintain bond-breaker conditions so joints don't bridge rigidly

A joint that's purely decorative but doesn't align with actual movement will eventually crack anyway.

Penetrations and Material Transitions

Light fixtures, signs, railings, louvers, and equipment supports all need coordination before stucco work begins. Improvising flashings and sealants around penetrations after the finish is installed rarely ends well.

The same logic applies where stucco meets brick, stone, metal panel, or curtain wall. Dissimilar movement rates and drainage paths can trap water at the interface. Enlarged detail drawings and a clear responsibility matrix, spelling out which trade installs each flashing and sealant, prevent gaps in accountability.

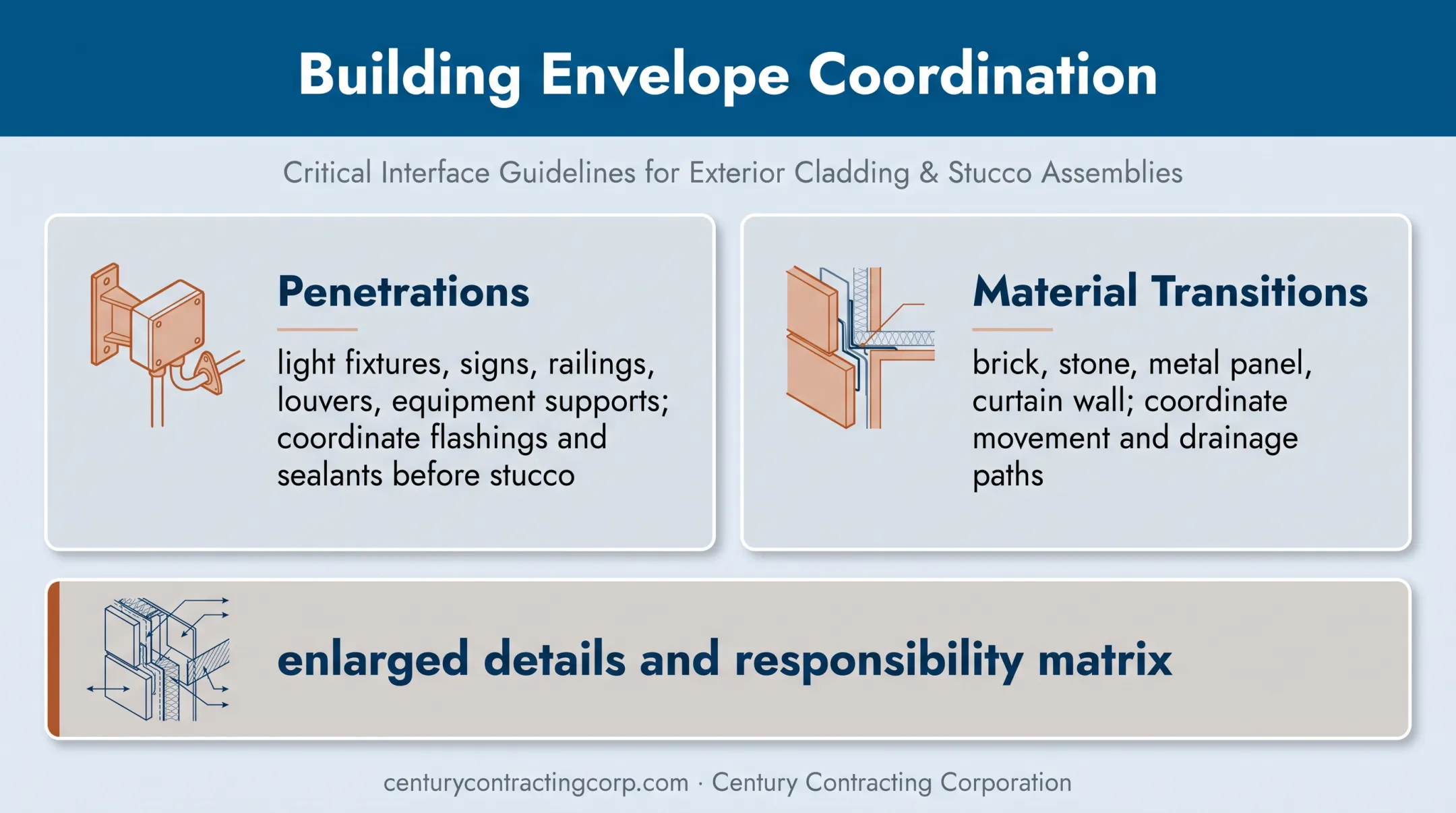

Stucco penetration and material transition coordination diagram

Choosing Finishes and Coordinating Façade Design

Choosing Finishes and Coordinating Facade Design

The "best" stucco finish isn't a fixed answer. It depends on the building's architectural language, viewing distance, scale, lighting, and how much maintenance the owner is willing to commit to long-term.

Common Finish Textures

Manufacturer finish names vary, so don't treat generic texture descriptions as standardized across systems:

Manufacturer Documented Finish Names
Dryvit (StucCoat) Standard, Fine, Bold, Lace
Sto (Powerwall) Fine, Medium, Swirl, Freeform
Parex (DPR Acrylic) Swirl Fine, Sand Smooth, Sand Fine, Sand Coarse
Senergy (Senerflex) Classic, Fine, Sahara, Texture

Texture affects more than appearance. Heavier textures create deeper shadow, hide substrate irregularities, and make future patches less obvious than a smooth finish would.

Color, Light, and Heat

Darker colors absorb more solar heat, which matters for EIFS in particular because the insulation board sits close to the finish. Sto's technical bulletin recommends a light reflectance value of at least 20 for North American vertical walls to limit overheating risk.

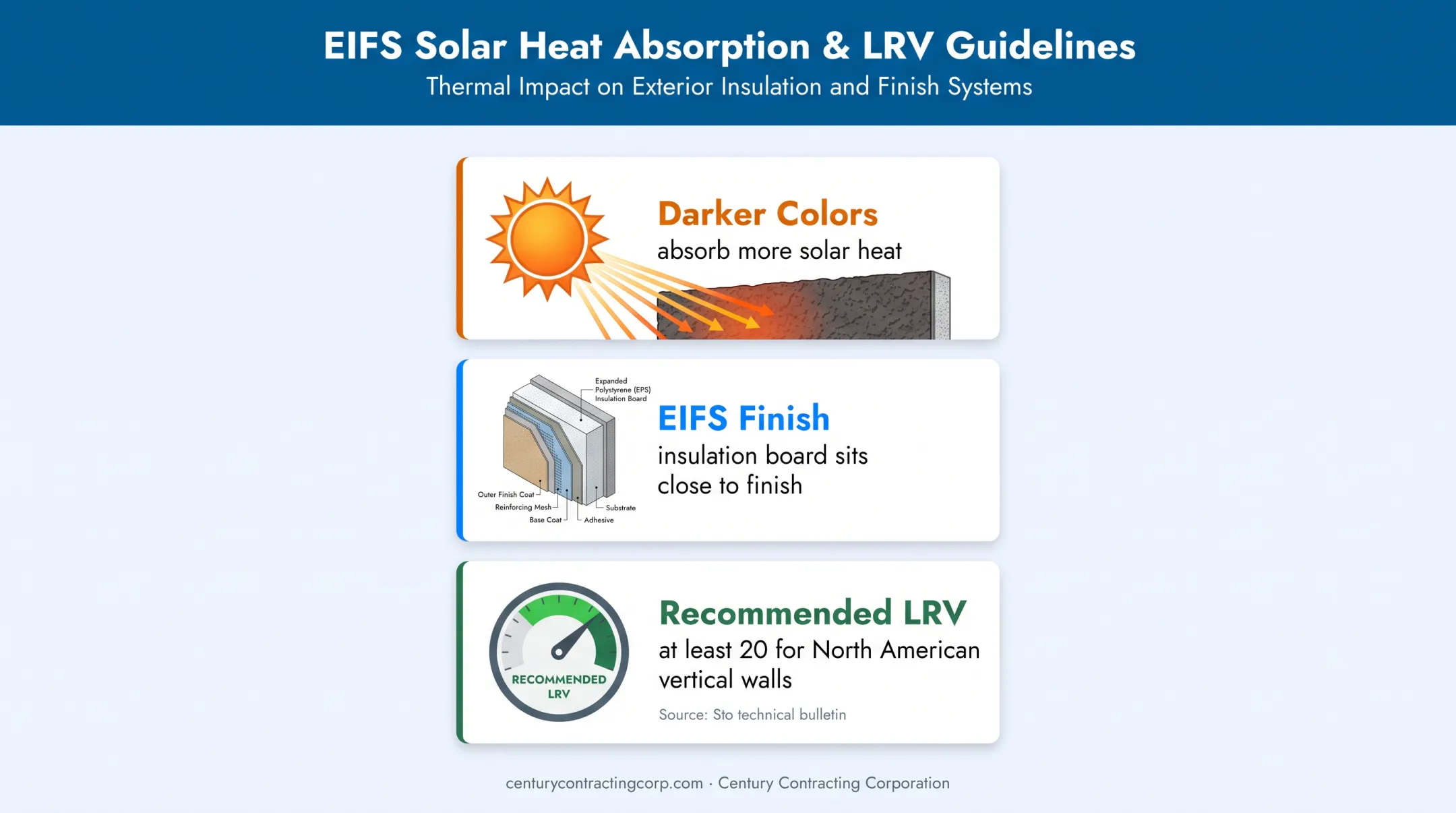

EIFS exterior color heat and light reflectance guidance

Before final approval, review color and texture mock-ups at representative scale, in the project's actual expected lighting conditions. A swatch under fluorescent office light tells you very little about how it reads at noon on a south-facing elevation.

A Quick Decision Framework

Weigh these factors when narrowing finish choices:

  1. Architectural style – match the texture to the building's overall language
  2. Exposure – factor in weathering, UV, and moisture on each elevation
  3. Impact risk – specify tougher finishes at loading docks and pedestrian zones
  4. Repair expectations – judge how visible future patches will be
  5. Budget and maintenance – account for finishes that need more frequent cleaning

Century Contracting self-performs commercial stucco and EIFS installation, coordinating the specified finish rather than selecting products independently of the design team. That distinction matters: the architect specifies, the contractor executes and flags constructability issues before they become field problems.

Installation, Quality Assurance, and Maintenance

Good detailing on paper only matters if it's executed correctly in the field, in sequence, with the right inspections along the way.

The Installation Sequence

A typical commercial sequence runs:

  1. Submittal and substrate review
  2. Mobilization and substrate preparation
  3. Barrier and flashing installation
  4. Reinforcement, then base and finish coats
  5. Curing, sealant completion, cleanup, and closeout

Before stucco application starts, confirm that rough openings, flashings, penetrations, and interfaces with other trades are actually ready, not just scheduled to be ready.

What to Inspect Before It's Covered

Concealed layers can't be fixed after the finish goes on, so document them while they're visible:

  • Continuity of air and water-resistive barriers
  • Drainage paths and lath or mesh laps
  • Fastener patterns and corner reinforcement
  • Coat thickness and curing conditions

Photographic documentation at each stage protects everyone if a question comes up later.

Reading Failure Signs

Cracking, staining, bulging, delamination, and sealant failure can stem from very different root causes. Sto links some EIFS cracking to aligned insulation-board joints, gaps between boards, or insufficiently overlapped reinforcement mesh. Separately, Dryvit identifies moisture entering through unsealed penetrations as a common cause of stucco delamination.

Stucco and EIFS failure signs with documented moisture causes

Diagnosis should come before repair. Surface shrinkage cracking needs a different fix than a drainage failure behind the wall, and patching over the wrong problem just delays the real repair.

Maintenance and Repair

Routine upkeep includes visual inspections, cleaning appropriate to the finish, and prompt repair of impact damage. Maintenance intervals depend on exposure, system type, and manufacturer guidance, so there's no single fixed schedule that applies everywhere.

For existing façades, repair strategies range from localized patching to full recladding, and the right choice depends on moisture assessment, substrate condition, and color/texture matching feasibility.

This is where credentials matter. Century Contracting's AWCI EIFSmart-certified workforce, manufacturer-certified applicator relationships with Dryvit, STO, Senergy, and Parex, and standard two-year installation warranty are worth verifying when selecting a contractor. Treat them as a starting point for due diligence, not a guarantee against every field condition.

Conclusion

A successful stucco facade comes from design intent matched with a properly coordinated wall assembly and carefully resolved transitions. Compatible layers, continuous water and air control, drainage, movement accommodation, accurate openings, approved finishes, and documented quality control all have to work together.

None of this happens by accident. Engaging a qualified commercial exterior wall contractor during design review and preconstruction, not after bidding closes, gives the team a chance to catch constructability issues while they're still cheap to fix on paper.

Frequently Asked Questions

What is the most attractive stucco finish?

It depends on the building's style, scale, lighting, and surrounding materials. Smooth finishes suit modern designs, while sand or lace textures hide substrate irregularities better on traditional buildings.

What is the difference between traditional stucco and EIFS?

Traditional stucco uses cement-based coats over lath or masonry, while EIFS is a layered system with insulation board, reinforced base coat, and synthetic finish. Project specifications determine which system fits the design and performance goals.

What layers are included in a commercial stucco wall assembly?

A typical assembly includes the substrate, water-resistive barrier, lath or reinforcement, plaster or EIFS coats, joint and flashing accessories, sealants, and finish coat. Exact configurations vary by system and manufacturer.

Where are stucco façade details most likely to fail?

Windows, doors, parapets, roof edges, base-of-wall conditions, penetrations, and movement joints see the most failures. These transition points require more careful detailing than the uninterrupted stucco field.

How can water intrusion be prevented behind a stucco façade?

Continuous water-resistive barriers, properly integrated flashings, drainage paths where specified, and sealed penetrations are the foundation. Compatible sealants and correct installation sequencing round out a reliable moisture-management strategy.
