Get any single layer wrong and the consequences show up fast: water intrusion behind the cladding, poor adhesion, cracking, uneven finish texture, reduced thermal performance, failed inspections, and warranty disputes that can drag on for months. That's why EIFS installation belongs to trained applicators working under qualified project managers, following the manufacturer's data sheets, approved drawings, and applicable building codes — not a generalist crew improvising details on the fly.
This guide walks through the full commercial installation workflow: planning, substrate prep, drainage, insulation, reinforcement, finish, interface detailing, and final validation.
Key Takeaways
- Treat EIFS as one tested system: never mix manufacturer components without written manufacturer approval.
- Control moisture through substrate prep, barrier continuity, drainage paths, flashing, and sealant placement.
- Install every layer in sequence, in suitable weather, following the manufacturer's written requirements.
- Pre-installation meetings, mockups, and concealed-layer inspections reduce warranty claims and performance risk.
- Complex commercial EIFS scopes need trained, certified applicators rather than a DIY approach.
EIFS System Installation Guide

Every commercial EIFS project follows the same basic sequence:
Preparation → substrate and drainage readiness → insulation attachment → reinforcement → finish application → interface detailing → inspection and documentation.
Before any material touches the wall, the schedule, crew coordination, lift and scaffold access, curing windows, and sequencing with other trades (window installers, roofers, sealant contractors) need to be locked in. Skipping this planning stage is where most schedule overruns and coordination conflicts begin.
Prerequisites and Safety Considerations
Before mobilization, confirm these items are in place:
- Approved construction documents, final EIFS system selection, and current manufacturer data sheets
- Code evaluations, shop drawings, and project submittals
- Clear written responsibilities for flashing, window interfaces, sealants, and adjacent cladding types
- Warranty terms and what they require from each trade
Substrate readiness matters just as much. The crew needs to verify substrate type, soundness, dryness, plane alignment, and proper attachment. The surface must also be free of dust, release agents, incompatible coatings, or deterioration that could block adhesion.

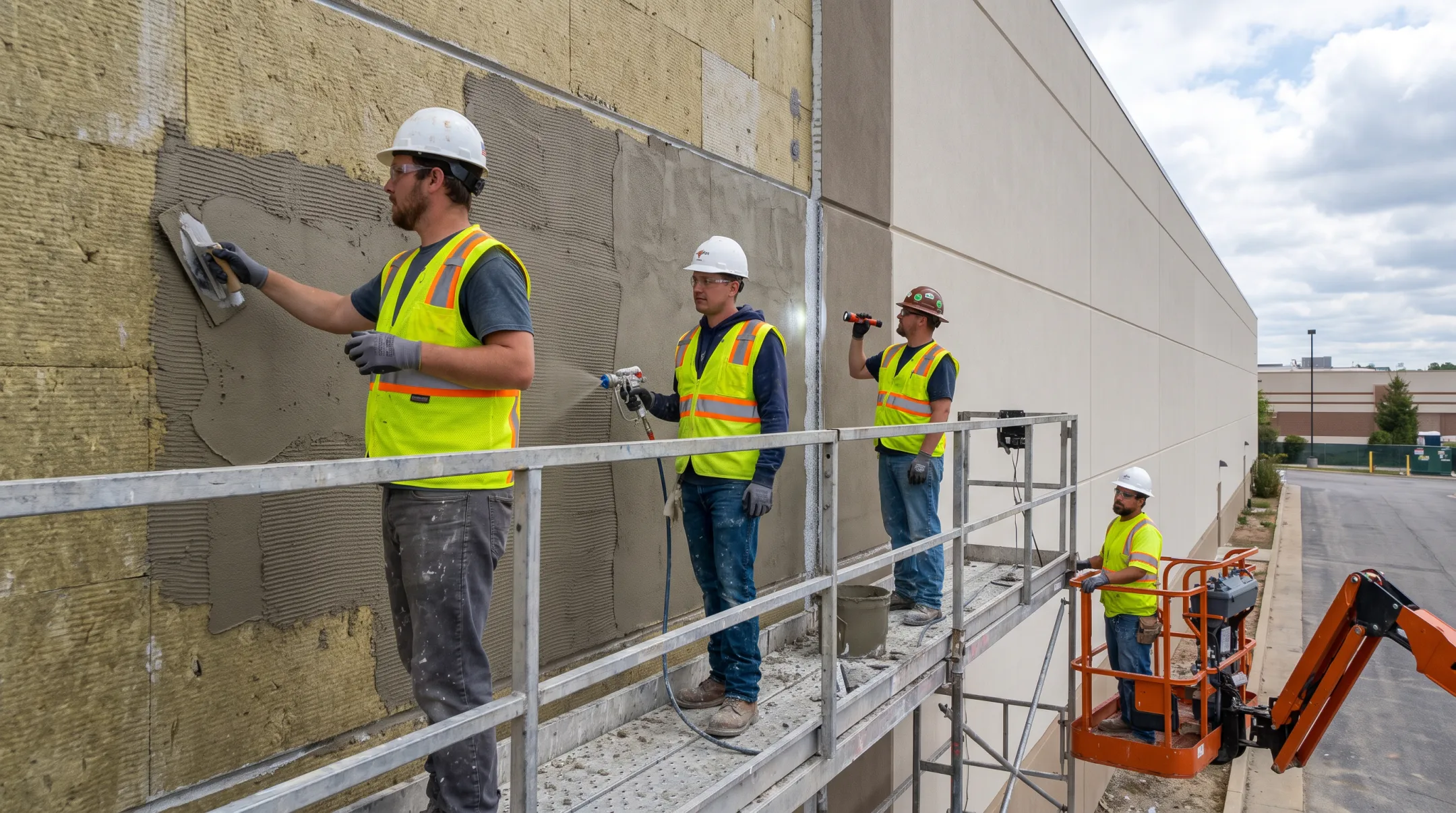

Safety planning belongs in the critical path on commercial EIFS scopes. Scaffolding, elevated work, insulation cutting, cementitious mixing, and dust exposure all carry real risk.
Under OSHA's scaffold standard, employees working more than 10 feet above a lower level require fall protection, and scaffolds need a competent-person inspection before every shift. Crews should have the right PPE on hand and follow the project's written safety plan without exception.
Before work begins, identify stop-work conditions, including:
- Unsuitable weather (temperature, precipitation, wind)
- Wet or damaged substrates
- Incomplete window and door openings or missing flashing
- Unapproved materials on site
- Unresolved design conflicts
- Unsafe access or untrained personnel on the crew
Tools and Parts Required
A typical commercial EIFS scope requires:
- Approved insulation boards and adhesive (plus mechanical fasteners where specified)
- Air and weather-resistive barrier and drainage accessories
- Reinforcing mesh, base coat, primer (where required), and finish coat
- Sealants, flashing, trims, and corner reinforcement
- Mixing equipment, trowels, straightedges, rasping tools, and thickness gauges
- Protection materials, scaffolding, and inspection documentation
Some of these items are essential system components; others are project-specific and can flex with design. Substitutions are acceptable only when the manufacturer, engineer, and specifications approve them in writing.
This is where a lot of installation problems start before the crew even picks up a trowel. EIMA's standard for EIFS construction requires that system components come from the selected manufacturer or its recognized component supplier. By default, components aren't interchangeable across brands.
Don't build a hybrid system by combining materials from Dryvit, Sto, Senergy, Parex, and other manufacturers without documented technical approval. Mixing components this way can void the warranty entirely, even when each product performs fine on its own.
How to Install EIFS Step by Step
Prepare the substrate and building-envelope interfaces. Complete repairs, confirm plane and tolerances, coordinate window and door openings, and resolve roof, deck, parapet, sill, corner, and penetration details before anything gets covered.
Install the air and weather-resistive barrier and drainage provisions. Apply the approved barrier continuously across the wall. Treat seams and penetrations, tie the barrier into openings and adjacent assemblies, and provide the specified drainage path with clear exit points at the bottom of the wall.
Attach the insulation boards. Use the approved adhesive and/or mechanical attachment method for the substrate and design. Stagger board joints, interlock corners, keep continuous joints away from opening corners, and rasp to a uniform plane. Fill gaps wider than about 1/16 inch with compatible foam.
Apply the base coat and embed reinforcing mesh. Mix material to spec, apply it consistently, and embed the mesh while the base coat is still workable. Reinforce corners and high-impact zones as designed, maintain proper mesh overlap at seams, and watch for exposed mesh, thin spots, or wrinkles. Those defects usually mean the application was rushed.
Apply primer and finish coat. Confirm the base coat has properly cured first. Match the approved color and texture against the mockup, keep a wet edge throughout, and protect adjacent surfaces from overspray. Controlling work areas carefully here prevents visible cold joints later.
Complete sealants, flashing, terminations, and transitions. Install compatible sealants at approved locations, preserve drainage and weep paths, and coordinate EIFS interfaces with roofs, windows, masonry, stone, and grade. Detail horizontal projections and exposed edges exactly as specified. These are the spots where most leaks start.

Post-Installation Checks and Validation
Once the finish coat cures, inspect the completed façade for:
- Plane consistency and finish color/texture uniformity
- Cracking, exposed mesh, or pinholes
- Impact damage or incomplete coverage
- Open joints, gaps, or staining
- Damage caused by other trades working nearby
Concealed items matter just as much as what's visible. Verify substrate and barrier acceptance, insulation attachment, reinforcement coverage, flashing and sealant continuity, and drainage exits before the next layer covers them.
Compare the finished work against approved drawings, manufacturer instructions, and mockups. Document weather conditions, inspection results, corrections, and photographs before closeout.
Skipping this step is a gamble. Concealed moisture pathways, weak bonds, or incompatible materials can stay hidden for months. They often surface later as leaks, finish failure, or a far more expensive repair bill.

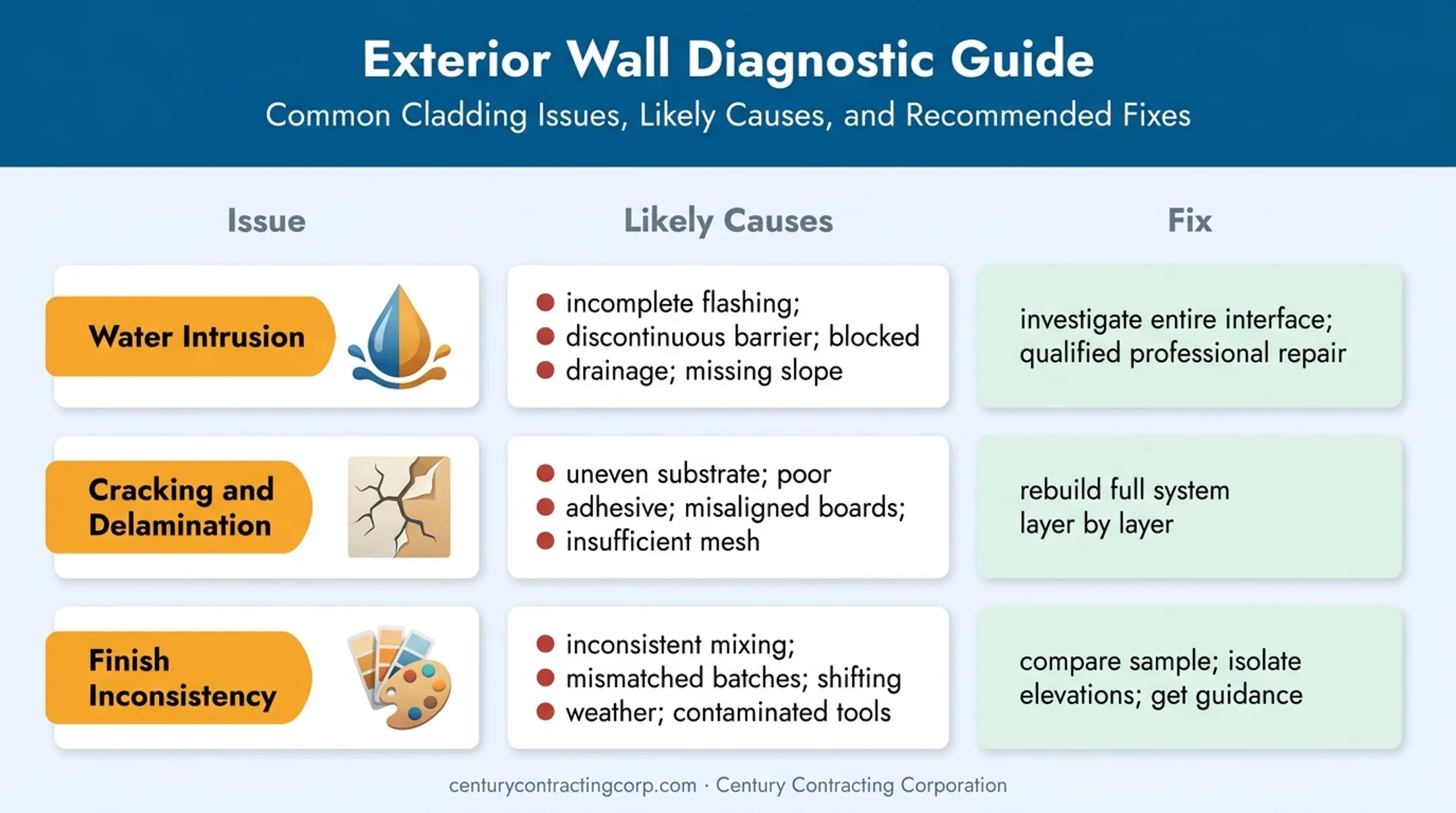

Common EIFS Installation Problems and Fixes
Problems should be diagnosed against the full wall assembly and manufacturer requirements, not patched cosmetically at the surface. A crack or stain at the finish coat is usually a symptom, not the actual defect.
Issue 1: Water Intrusion at Openings, Transitions, or Terminations
Problem: Leaks or moisture damage show up around windows, doors, roof lines, penetrations, or the bottom of the wall.
Likely causes:
- Incomplete flashing integration
- Discontinuous weather-resistive barrier
- Blocked drainage
- Missing slope
One documented failure mode: sealing or back-wrapping the bottom edge of a drainage EIFS wall can trap water behind the cladding instead of letting it exit. That detail does the opposite of what it should.
Fix: Stop water entry immediately and investigate the entire interface, not just the visible stain. Bring in a qualified EIFS or building-envelope professional to repair and verify the detail.
Issue 2: Cracking, Delamination, or Uneven Surfaces
Problem: Cracks, hollow spots, ridges along board joints, or finish delamination appear after installation.
Likely causes:
- Damaged or uneven substrate
- Inadequate adhesive coverage
- Poorly aligned boards
- Insufficient mesh overlap
- Incorrect base-coat thickness
Fix: Determine whether the defect is localized or spread across the elevation. Remove unsound material where needed and correct the underlying cause, then rebuild the full system layer by layer rather than slapping an unapproved patch over the surface.
Issue 3: Finish Color, Texture, or Curing Inconsistency
Problem: The façade shows color variation, visible cold joints, powdering, blistering, or premature surface wear.
Likely causes:
- Inconsistent mixing
- Mismatched product batches
- Shifting weather during application
- Contaminated tools
- Finish applied before the base coat was ready
Fix: Compare the installed work against the approved sample and manufacturer requirements. Isolate the affected elevations and get technical guidance before recoating or blending finish material.

Pro Tips for Installing EIFS Effectively
A few practices separate smooth EIFS projects from ones that end up in a dispute:
- Hold a documented pre-installation meeting with the owner, architect, GC, EIFS sub, window/flashing trades, sealant contractor, and manufacturer rep. Confirm sequencing, responsibilities, and weather protection.
- Build mockups with hold points for substrate prep, barrier and flashing interfaces, insulation layout, reinforcement, and finish appearance before production starts.
- Plan around weather, not just the calendar. Temperature, precipitation, wind, and humidity all affect curing. Protect new work from damage by nearby trades.
- Keep a full project record: approved product data, installer qualifications, photos before concealment, inspection reports, corrective actions, and warranty documents.
- Bring in a qualified commercial EIFS subcontractor for projects with multiple substrates, complex transitions, difficult access, or uncertain moisture conditions.
This last point is where a lot of GCs and architects get tripped up. They treat EIFS as standard subcontractor scope rather than a specialized trade.
Century Contracting Corporation has installed EIFS, stucco, air and weather barriers, stone, and exterior wall panels across the Mid-Atlantic for more than 30 years. Crews are AWCI EIFSmart-certified, with applicator credentials from Dryvit, Sto, Senergy, Parex, and other major manufacturers.
That depth matters most on projects where a generalist crew is most likely to miss a detail.

Conclusion
EIFS performance comes down to one principle: treat the façade as a complete engineered wall assembly. Substrate prep, barrier continuity, insulation attachment, reinforcement, finish, and interface detailing each depend on the step before them.
These are not optional extras if you want decades of service instead of failure by year three:
- Careful planning and approved system components
- Trained installers and moisture-focused detailing
- Documented inspections at each critical stage
If you're preparing specifications, bidding envelope work, or evaluating installation quality on a commercial project, bring in a qualified EIFS professional before the details lock in on paper. Century Contracting Corporation is an AWCI EIFSmart-certified installer with over 30 years on commercial and institutional envelopes, and early review is when assembly details are still inexpensive to get right.
Frequently Asked Questions
What is the average cost to install EIFS per square foot?
Get a project-specific bid from your drawings and scope—generic square-foot ranges rarely hold up. Price depends on system type, insulation thickness, substrate condition, building height, access, detailing, and finish.
What is an EIFS system?
EIFS is a multi-layer exterior wall assembly. It typically includes an air and weather-resistive barrier, drainage provisions, insulation board, reinforcing mesh, base coat, finish coat, plus related flashing and sealants.
Can EIFS be applied to stucco?
It depends on the existing stucco's condition, attachment, moisture history, and surface characteristics, along with the specific manufacturer-approved assembly being used. Have a qualified contractor evaluate the substrate before assuming it's suitable.
Which is better, stucco or EIFS?
Neither is universally better. Insulation performance, moisture management, impact exposure, substrate conditions, code requirements, budget, and installer qualifications should all factor into the decision for your specific building.
