Many property owners assume the finish is just a cosmetic topcoat. In reality, it's the last link in a chain that includes the wall assembly, air barriers, flashing, and drainage details. Miss one link, and the whole chain fails.
Trained stucco and exterior wall professionals should handle commercial installations, especially where the finish interfaces with air barriers, flashing, windows, control joints, penetrations, or EIFS assemblies. Incorrect installation can lead to adhesion failure, peeling, cracking, uneven color or texture, moisture intrusion, costly rework, and warranty disputes.
This guide covers acrylic stucco preparation, tools and materials, application sequence, finish selection, inspection, troubleshooting, and when to bring in a qualified contractor.
Key Takeaways
- Acrylic stucco is flexible and color-integrated, yet still needs a sound, prepared substrate
- Confirm the approved wall assembly, primer, base coat, mesh, and finish before work begins
- Batch control, uniform thickness, and a wet edge keep texture and color consistent
- Inspect transitions, joints, penetrations, and drainage details before accepting finished work
- Commercial projects require experienced crews with documented QC and warranty backing
Installation Guide for Acrylic Stucco
The process generally runs through four phases:
- Specification and substrate preparation
- Base-system installation
- Primer and acrylic finish application
- Post-installation inspection and protection
Installation time, labor requirements, and working windows vary with building size, substrate condition, product system, access, weather, texture, and project sequencing. There's no universal timeline here. Always reference the manufacturer's current documentation for the specified product system rather than a generic schedule.
Prerequisites and Safety Considerations
Before anyone picks up a trowel, confirm the approved assembly. Is acrylic stucco being applied over a compatible cementitious base, existing stucco, EIFS, masonry, or another manufacturer-approved surface? This determines everything downstream, including primer selection and cure requirements.
Inspect the substrate for:
- Loose material, dust, or grease
- Efflorescence or deteriorated stucco
- Active leaks or excessive moisture
- Structural movement
These conditions must be corrected before any coating goes on. Dryvit's technical bulletin identifies efflorescence on cementitious base coats as a bond breaker that can prevent finish adhesion and cause blotchy appearance; it needs to be removed, not covered up (Dryvit Efflorescence Bulletin).
Verify that weather-resistive barriers, flashing, drainage, control joints, sealants, trims, and openings are installed and sequenced correctly. The finish should never conceal unresolved water-management problems.
Weather matters more than most crews realize. ANSI/EIMA requires a minimum substrate temperature of 40°F (4.4°C) during installation and for 24 hours afterward, with protection from precipitation and extreme humidity (ANSI/EIMA 99-A-2001).
Jobsite safety is non-negotiable:
- Scaffolds require inspection by a competent person before each shift
- Workers above 10 feet need fall protection appropriate to the scaffold type
- Eye, face, and respiratory protection apply based on the specific hazard present
- Material handling and overhead work need documented procedures
Do not proceed over an unstable, contaminated, wet, or incompatible substrate, or when conditions fall outside the manufacturer's stated requirements. There's no shortcut around this.
Tools and parts required. Every acrylic stucco job needs a defined set of materials and tools. Here's the typical checklist:
- Approved acrylic finish, primer, and compatible base coat with reinforcing mesh where required
- Clean mixing paddles, buckets, stainless-steel trowels, and floats
- Sprayers, where approved for the product
- Masking materials, drop cloths, and cleaning supplies for tools and overspray
- Compatible sealants and backer rod
- Scaffolding, lifts, or other access equipment
Separate what's specified from what's optional. The base coat, mesh, primer, and finish are system components. Substitutes shouldn't be used unless approved by the manufacturer or design professional. A trowel brand is a preference; swapping a different manufacturer's base coat into a specified system is not.
Large commercial elevations may call for calibrated spray equipment and additional material staging. Clean tools aren't a nicety. Contaminated equipment is one of the quieter causes of blotchy finish and lap marks.

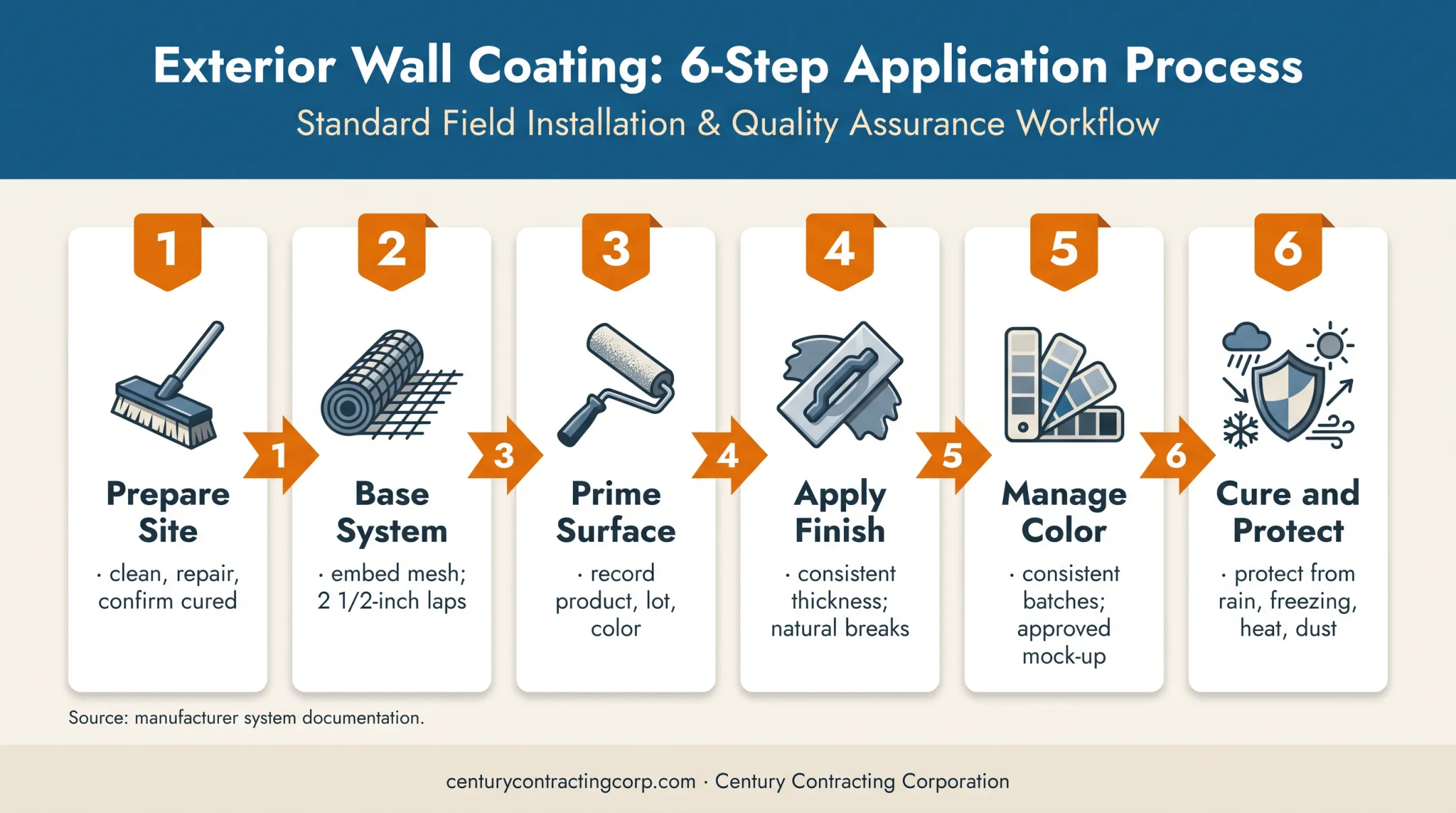

How to Install Acrylic Stucco (Step-by-Step)
1. Prepare the site. Protect adjacent surfaces, establish work areas, and review the elevation-by-elevation sequence. Clean the substrate, repair any defects, and confirm the base coat or existing stucco is cured, sound, dry, and properly profiled.
2. Install or verify the base system. Apply the specified base coat and reinforcing mesh where required. Mesh must be fully embedded without wrinkles, and laps at edges typically need at least 2½ inches (64 mm) of overlap, per manufacturer system documentation. Confirm transitions at corners, openings, joints, and dissimilar materials are properly treated.
3. Prime the surface. Use the manufacturer-approved primer to promote uniform adhesion and support consistent color and texture. Document the product name, lot number, color, and application conditions — this record matters later if a color inconsistency shows up.
4. Apply the acrylic finish. Work in manageable sections. Maintain consistent thickness and pressure, follow the selected texture technique, and coordinate adjacent applicators so lap marks don't appear in visible locations. Stop only at natural breaks (corners, joints, reveals), never mid-wall.
5. Manage color and texture. Use consistent batches and mixing procedures. Confirm the work matches the approved sample or mock-up. Protect completed areas from dust and impact while adjacent sections are finished.
6. Cure and protect. Follow the product's required drying and curing conditions. Protect the wall from rain, freezing, excessive heat, dust, and impact. Don't remove protection until the finish is actually ready. Manufacturers like Sto note drying times extend significantly in cool or damp conditions, so a calendar guess isn't good enough.

There's no single drying number that applies across brands. Sto's Stolit finish dries within 24 hours under conditions of 70°F and 50% relative humidity, but that's a reference point, not a guarantee for every jobsite.
Post-Installation Checks and Validation
Before accepting finished work, inspect for:
- Uniform color, texture, and coverage
- Consistent adhesion and thickness where measurable
- Clean terminations and protected edges
- Acceptable transitions around openings and penetrations
Check that cracks, blisters, pinholes, exposed mesh, voids, delamination, and visible lap marks are either absent or corrected according to the approved repair procedure. Confirm drainage paths, flashing, sealants, and joints remain functional. The finish should never block or bridge a drainage detail.
Documentation is the part crews skip, and it saves you later. Record inspections, material batches, weather conditions, mock-up approval, and any corrective work. Skipping validation turns small application defects into concealed, expensive failures down the road.

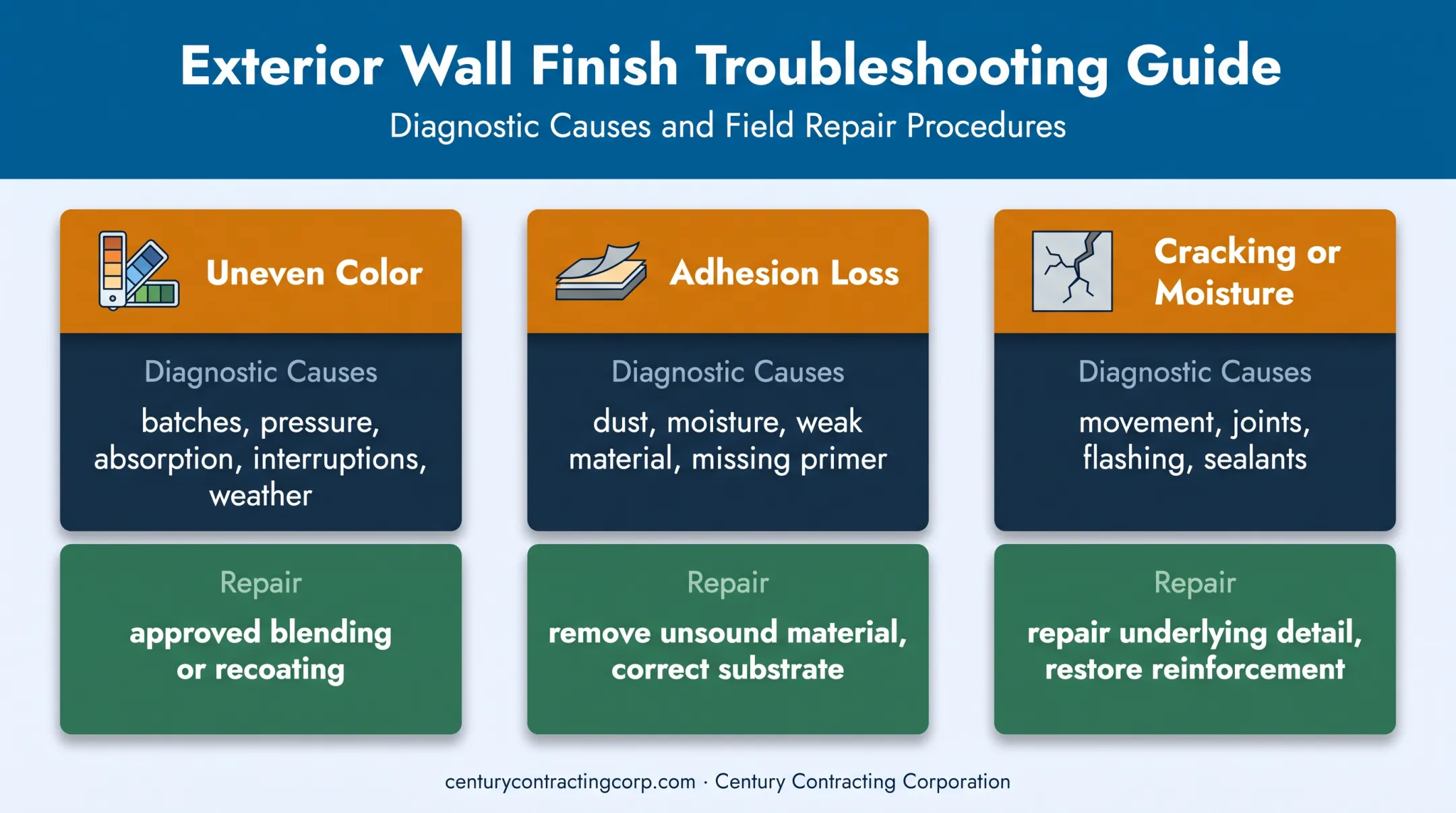

Common Installation Problems and Fixes
Most acrylic stucco failures trace back to one of five root causes: substrate condition, incompatible materials, poor moisture management, inconsistent application, or work performed outside product requirements.
Uneven Color or Texture
The problem: Visible color variation, lap marks, inconsistent aggregate distribution, or texture differences across adjacent sections.
Likely causes:
- Inconsistent batches or mixing procedures
- Changing application pressure between crew members
- Varying substrate absorption rates
- Work interruptions without planned breaks
- Poor crew coordination or application in unsuitable weather
The fix: Identify the affected area and follow the manufacturer's approved blending or recoating procedure. Going forward, lock down batch control, crew sequencing, and wet-edge coordination so color and texture stay consistent.
Adhesion Loss, Peeling, or Blistering
The problem: The acrylic finish separates from the substrate, bubbles, or peels after installation.
Likely causes:
- Dust, dirt, or moisture trapped under the finish
- Weak or incompatible existing material
- Missing or incorrect primer
- Application over a surface that wasn't ready
The fix: Stop covering the problem immediately. Determine whether the failure is superficial or assembly-related, then remove unsound material, correct the moisture or substrate issue, and reinstall only with compatible materials and documented preparation.
Dryvit's repair guidance is clear: improper curing and inadequate substrate preparation often cause localized finish failure. The lasting fix is removal and reinstallation—not a patch over the top.
Cracking or Moisture Intrusion
The problem: Cracks appear in the finish, or water enters around joints, openings, penetrations, or transitions.
Likely causes:
- Movement in the substrate
- Inadequate joint or flashing details
- Failed sealants
- Improper base-system installation
The fix: Classify the crack or leak before touching it. Repair the underlying detail, restore compatible sealants or reinforcement, and follow the manufacturer's repair method. Filling a crack and painting over it without fixing the cause is temporary. The defect usually returns, and often worse.

Pro Tips for Installing Acrylic Stucco Effectively
Use a project-specific mock-up. Approve color, texture, thickness, transitions, and workmanship before full production starts. Keep the approved reference on hand for quality-control comparisons throughout the job.
Schedule around weather, not around the calendar. Acceptable temperature, humidity, wind, sunlight, and precipitation conditions should drive sequencing. Coordinate crews so adjacent elevations finish without avoidable cold joints or visible transitions.
Keep detailed records. Product names, lot numbers, primers, substrate repairs, weather conditions, inspection results, and any approved deviations from the specification. All of it matters if a warranty claim comes up later.
Bring in a specialist when the project involves:
- Multiple exterior wall systems on one building
- Occupied commercial facilities
- Extensive repairs or uncertain substrate conditions
- Complex penetrations
- A schedule demanding multiple coordinated crews
Complex acrylic stucco scopes reward crews that have already worked through the hard cases. Century Contracting Corporation has handled this work for Mid-Atlantic commercial clients since 1994. The company holds a Class A contractor license, employs an AWCI EIFSmart-certified workforce, and carries certifications from major EIFS manufacturers including Dryvit, STO, Senergy, and Parex.
Every Century Contracting project gets a dedicated project manager, superintendent, and foreman rather than a rotating cast of supervisors. Installations include a standard two-year warranty, which matters when adhesion or cracking issues appear months after substantial completion.
With more than 30 years in the field and over 3,000 completed projects, the firm has seen most of the failure modes covered in this guide firsthand.

Conclusion
Acrylic stucco finish quality depends on the complete wall assembly and installation process, not just the appearance of the final coat. A beautiful topcoat over a poorly prepared substrate is a problem waiting to surface, usually after the crew has left the site.
These steps matter more than the finish product itself:
- Careful specification review
- Thorough substrate preparation
- Controlled application
- Weather-aware sequencing
- Detailed inspection
For commercial or technically complex projects, professional installation determines whether a wall performs for decades or needs rework within a year.
Frequently Asked Questions
Is acrylic stucco worth it?
Acrylic stucco can be worthwhile when its color flexibility, water resistance, and compatibility with the wall assembly match the project's needs. Installation quality and substrate preparation strongly affect whether that value is actually realized.
Is acrylic stucco better than cement stucco?
Acrylic offers more flexibility, color consistency, and moisture resistance; cement stucco offers a traditional appearance, breathability, and often lower initial material cost. Neither is universally better — it depends on the project's climate, substrate, and aesthetic goals.
Can acrylic stucco be applied over existing stucco?
Only when the existing stucco is sound, clean, dry, compatible, and properly prepared. Active moisture, loose finish material, and substrate defects must be corrected before any new coating goes on.
What preparation is needed before applying acrylic stucco?
Preparation includes cleaning, removing unsound material, repairing defects, checking for moisture, and confirming compatibility with the specified primer and base coat. Always protect adjacent surfaces and follow the manufacturer's current instructions.
How long does acrylic stucco take to cure?
Cure and drying time depend on the specific product, temperature, humidity, wind, sunlight, substrate, and coat thickness. Check the product data sheet for the specified system rather than relying on a general timeline.
Can acrylic stucco be repaired if it cracks or peels?
Minor finish defects may be repairable with the manufacturer's approved procedure. Peeling, recurring cracks, or moisture-related damage requires diagnosing the substrate and wall assembly before any patching or recoating happens.
